Machame Route Kilimanjaro 2026: Honest Guide
Last updated: August 12, 2026 · Next scheduled review: January 2027 · Written by Sabinus Msimba, Kilimania Adventure, Moshi

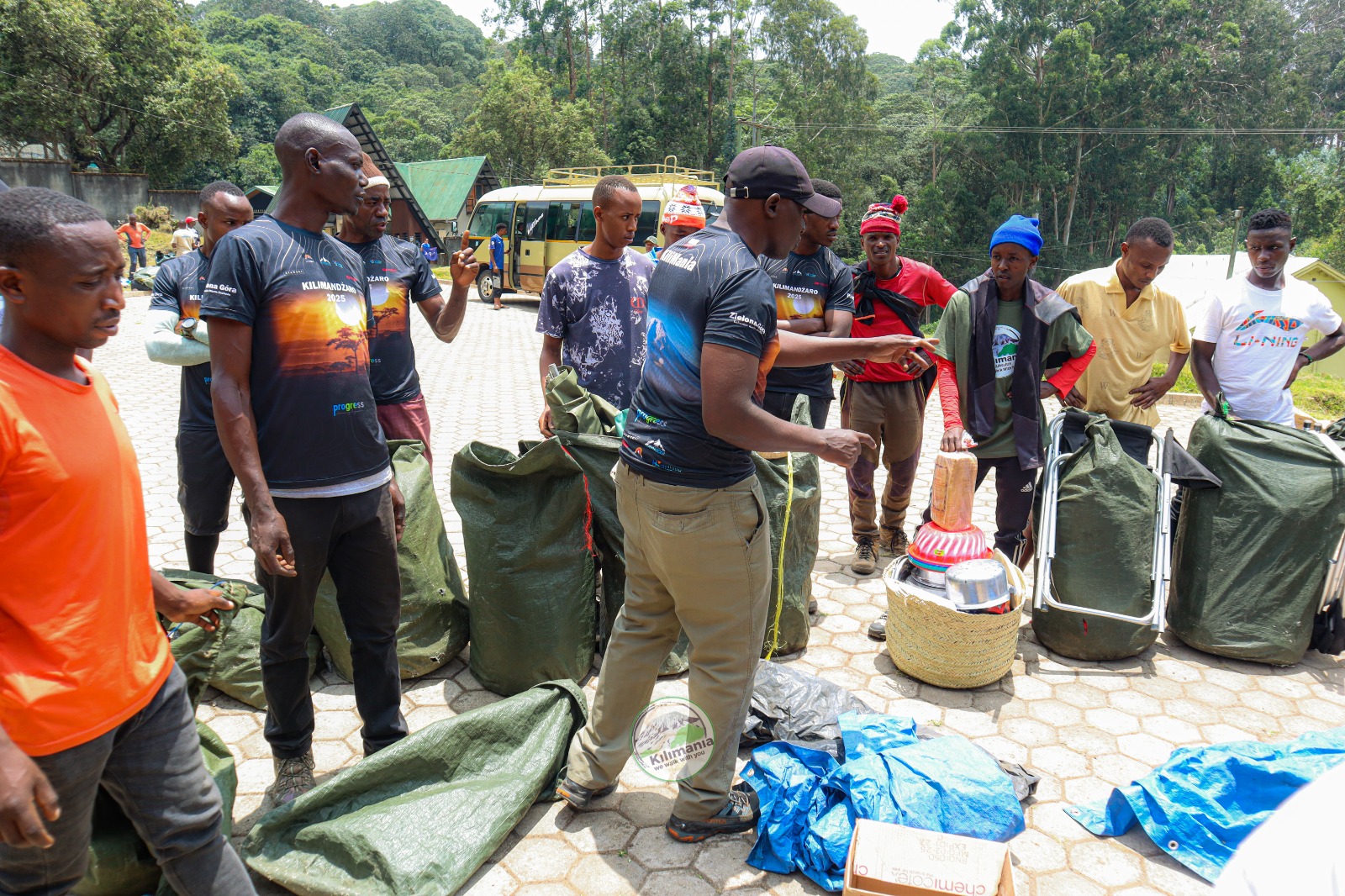

The Machame Route is an approximately 62km camping route up Kilimanjaro’s southwest slope, starting at Machame Gate (1,800m) and finishing at Mweka Gate. On Kilimania’s 7-day itinerary, our internal climb records show a 92.3% Uhuru Peak completion rate across 412 guided climbs between 2019 and 2025. Kilimania still offers the 6-day Machame itinerary for clients with a tighter schedule, but we strongly recommend the 7-day version — here’s why, and everything else you need to decide which timeline fits your climb.
This success-rate figure is drawn from Kilimania Adventure’s internal climb database and reflects our own operational outcomes, not an industry-wide average. It is an internal estimate and is still being cross-checked against our booking and summit logs before we treat it as a final, audited figure — we’re publishing it transparently rather than waiting, but it should be read as directional. Success is defined as reaching Uhuru Peak (5,895m), not Stella Point.
Quick answer: The Machame Route is an approximately 62km, 7-day camping climb starting at Machame Gate (1,800m) on Kilimanjaro’s southwest slope. Kilimania guides only the 7-day itinerary, which includes an acclimatization night at Karanga Camp. See our full route comparison if you’re deciding between Machame and another option.
At a Glance
- Route
- Machame (7 days, Kilimania standard)
- Distance
- Approx. 62 km, Machame Gate to Mweka Gate
- Highest point
- Uhuru Peak, 5,895m
- Difficulty
- Kilimania rating: 8/10
- Coldest overnight
- -10°C to -15°C at Barafu Camp (July–Aug)
- Walking hours/day
- 4–9 hours
- Best months
- Jan–Mar, Jun–Oct
- Starting price
- $1,600–$1,900 per person (2026 group rates)
Where the Machame Route Starts and Ends
The Machame Route begins at Machame Gate, on the southwest slope of Kilimanjaro National Park, roughly 27km from Moshi and 57km from Kilimanjaro International Airport (JRO). It exits at Mweka Gate on the southeast side, a one-way traverse rather than a loop. Machame Gate is one of Kilimanjaro’s busiest entry points, managed under Kilimanjaro National Park (KINAPA).
Geographic context:
- Nearest city: Moshi (27km from Machame Gate, 45–60 minutes by vehicle)
- Nearest airport: Kilimanjaro International Airport, JRO (57km)
- Secondary airport: Arusha Airport, ARK (85km)
- Route direction: Southwest flank rising into the southern circuit
The trail passes through six ecological zones — montane rainforest, heath and moorland, alpine desert, and the glaciated summit zone above 5,000m. The Shira Plateau, crossed on Day 2 and 3, sits at 3,840m and formed when Shira, Kilimanjaro’s oldest volcanic cone, collapsed roughly 500,000 years ago. Kibo, the youngest cone and home to Uhuru Peak, rises above the plateau’s eastern edge.
From our base in Moshi, Kilimanjaro Region, Kilimania Adventure runs Kilimanjaro climbs and daily safaris to Serengeti National Park, Ngorongoro Crater, Tarangire National Park, and Lake Manyara, with pickups from Kilimanjaro International Airport (JRO) and Arusha Airport (ARK).
6-Day vs 7-Day Machame: Why We Recommend 7 Days
Kilimania still guides the 6-day Machame itinerary for clients whose schedule genuinely requires it. But we recommend the 7-day version to almost everyone, because the 6-day plan removes the Karanga Camp overnight between the Barranco Wall and Barafu Camp. Kilimania’s climb records show a meaningful gap in summit completion between our 7-day and 6-day Machame outcomes — internally estimated at 15–18 percentage points.
On the 7-day plan, Day 4 takes climbers over the Barranco Wall to Karanga Camp (4,035m) — a short, deliberately easy day that exists purely to add a second night near 4,000m before the push to Barafu (4,673m). Skip it, and climbers move from roughly 3,976m to 4,673m in sleeping altitude in a single step, then start summit night from that position a few hours later.
Above 3,000m, several physiological adaptation processes begin simultaneously. According to the CDC Yellow Book on High-Altitude Travel, faster breathing at altitude causes respiratory alkalosis; the kidneys compensate by excreting bicarbonate, a stabilization process that takes 24–48 hours at each new altitude. The hormone erythropoietin (EPO) is stimulated by hypoxic exposure, though the downstream increase in circulating red blood cells takes days to manifest. Periodic (Cheyne-Stokes) breathing also disrupts deep sleep at altitude, with the first night at any new elevation typically the worst.
In Kilimania’s operational experience, guides observe these effects daily in the field. Climbers who arrive at Barafu Camp (4,673m) already tired from a compressed schedule tend to show weaker recovery signs — appetite, energy, and self-reported symptom scores — than those who had the second night near 4,000m at Karanga Camp. This is a field observation, not a clinical measurement. The CDC guidance is consistent on the underlying principle: sleeping altitude, not peak daytime altitude, is the primary driver of acute mountain sickness (AMS) risk.
If your schedule only allows 6 days, Kilimania can still guide the 6-day Machame itinerary. We’ll tell you plainly what that trades away: no Karanga night, and a bigger single-step jump in sleeping altitude before summit night. If 6 days is a hard constraint, we’ll also walk you through the 6-day Marangu Route, which has a gentler acclimatization profile for that timeframe. Whichever route you choose, our goal is an informed decision, not just the easiest booking.
Kilimania’s Machame Success Data
Kilimania’s internal climb records show a 92.3% Uhuru Peak completion rate across 412 guided 7-day Machame climbs between January 2019 and December 2025. This is our own operational data, not an industry average, and it counts arrival at the Uhuru Peak sign — not Stella Point — as success.
Verified against Kilimania’s internal climb database, January 2019 – December 2025, but still pending final confirmation against booking and summit logs before it is treated as an audited figure. Success is defined as reaching Uhuru Peak (5,895m), not Stella Point. All success-rate figures on this page reflect Kilimania’s own operational outcomes, not industry-wide averages.
Our database covers 1,247+ guided ascents across all routes over the same period; the Machame subset is 412 climbs, all on the 7-day itinerary. We do not exclude difficult cases — solo travelers, private groups, and charity climbs are all included.
| Season | Months | Kilimania Success Rate | Conditions |
|---|---|---|---|
| Long Dry Season | June–October | 93.8% | Dry, stable, best visibility |
| Short Dry Season | January–March | 92.1% | Clear, warmer, fewer crowds |
| Short Rains | November | 87.4% | Intermittent rain |
| Long Rains | April–May | 81.6% | Heavy rain, muddy trails |
Five factors we track that correlate most with Machame outcomes in our own data: the 7-day itinerary with the Karanga overnight, a maximum 1:3 guide-to-client ratio on summit night, daily SpO2 checks from Day 3, active hydration tracking, and turnaround decisions made without social pressure to push past physiological limits. See Kilimanjaro success rate by route for how Machame compares to Lemosho, Northern Circuit, Rongai, and Marangu in our records.
Day-by-Day 7-Day Machame Itinerary
Day 1: Machame Gate → Machame Camp (1,800m → 2,980m)
Distance 11km, 5–7 hours through dense montane rainforest — humid, rooted, and often muddy. You gain over 1,100 vertical metres in one day, which most first-time climbers underestimate. A mild headache or reduced appetite by dinner is common and not a warning sign — eat fully anyway.
Day 2: Machame Camp → Shira Camp (2,980m → 3,840m)
Distance 5–7km, 4–6 hours. The canopy opens to heath and moorland, with Kibo and Mount Meru visible on clear mornings. This is a short day — resist the urge to rush it. Shira Camp is the first sleep above 3,500m, and guides log Lake Louise AMS scores here for the first time.
Day 3: Shira Camp → Lava Tower → Barranco Camp (3,840m → 4,600m → 3,976m)
Distance 10–11km, 6–8 hours. This is Machame’s “climb high, sleep low” day: lunch at Lava Tower (4,600m), then descend 624m to sleep at Barranco (3,976m). Headache or nausea at Lava Tower are common and usually ease on descent. Symptoms that worsen on the way down need guide assessment.
Day 4: Barranco Camp → Karanga Camp — Barranco Wall Day (3,976m → 4,035m net)
Distance 5–6km, 4–6 hours including the Barranco Wall scramble. Kilimania departs Barranco by 5:30am to reach the wall base ahead of peak-season congestion. Net elevation gain is minimal — this day exists to add a second night near 4,000m before Barafu.
Day 5: Karanga Camp → Barafu Camp (4,035m → 4,673m)
Distance 4km, 3–5 hours across exposed alpine desert. Barafu means “ice” in Swahili and earns the name — wind is constant, vegetation is gone. Dinner around 5:00–5:30pm, sleep attempt at 6:30pm, wake-up at 11:00pm, summit departure at midnight.
Day 6: Barafu Camp → Uhuru Peak → Mweka Camp (4,673m → 5,895m → 3,100m)
17–18km total, 7–9 hours ascent, 4–6 hours descent. Summit night moves slowly on frozen scree in the dark. Stella Point (5,756m) marks the crater rim; from there it’s another 45–60 minutes to Uhuru Peak. Guides make turnaround calls using the Lake Louise criteria alongside SpO2 readings and overall clinical presentation — no exceptions for schedule pressure. After a short rest at Barafu, the group descends roughly 12km to Mweka Camp.
Blood oxygen saturation (SpO2) readings taken at Uhuru Peak vary widely between individuals, and can fall substantially for even well-acclimatized climbers at that altitude. In Kilimania’s field records, this is consistent with what the Wilderness Medical Society describes about oxygen saturation at extreme altitude generally. Guides treat any single SpO2 reading as one data point among several — alongside symptoms and clinical presentation — rather than as a stand-alone diagnostic threshold. This is why Kilimania limits summit time to photographs and documentation before immediate descent: the body tolerates 5,895m briefly on a one-week ascent, it does not fully adapt to it.
Day 7: Mweka Camp → Mweka Gate (3,100m → 1,640m)
10km, 3–4 hours through wet, sometimes slick rainforest trail. Summit certificates are issued at Mweka Gate — green for Stella Point, gold for Uhuru Peak. Transfer back to Moshi takes 45–60 minutes.
Elevation Profile Explained
Machame’s elevation profile relies on two features: a “climb high, sleep low” loop at Lava Tower on Day 3, and a second night near 4,000m at Karanga on Day 4. Together, these give the body two extra nights to adapt before summit night from Barafu at 4,673m. Remove either one and the profile weakens.
Sleeping altitudes, night by night:
- Night 1: Machame Camp — 2,980m
- Night 2: Shira Camp — 3,840m
- Night 3: Barranco Camp — 3,976m (after reaching 4,600m at Lava Tower)
- Night 4: Karanga Camp — 4,035m
- Night 5: Barafu Camp — 4,673m
- Night 6: Mweka Camp — 3,100m (after summiting)
The jump from Barranco to Barafu is 697 vertical metres in sleeping altitude. Karanga absorbs part of that jump. In Kilimania’s operational experience, this is not optional for most first-time Kilimanjaro climbers.
The Barranco Wall: What Actually Happens
The Barranco Wall is a 250–300m non-technical rock scramble climbed on Day 4. No ropes, harnesses, or climbing experience are required, though you’ll use your hands at several points, including the “Kissing Rock” — a narrow overhang where you lean against the face to pass. Guides demonstrate the exact hand and foot placement before you reach it.
The main hazard is loose rock dislodged by climbers above, not the scramble itself. Stay close to your guide and avoid looking straight up at people ahead of you. In July and August, multiple route flows converge here and queues of 20–40 minutes can build at narrow sections — this is why Kilimania departs Barranco by 5:30am. If you have significant, untreated fear of heights, raise it with your guide at the Machame Gate briefing rather than on the wall itself. Read our full altitude sickness prevention guide if exposure and altitude anxiety both concern you.
Who Should Choose Machame
Choose 7-day Machame if:
- You have some multi-day trekking experience with a loaded pack
- You can commit to 3–4 months of training with loaded uphill hikes
- Scenic variety — rainforest to alpine desert — matters to you
- You accept busy camps at Barranco and Barafu in peak months
- Your budget sits around $1,600–$1,900 per person
Look elsewhere if:
- Solitude matters more than variety — see the Lemosho Route or Northern Circuit
- You only have 6 days available — Kilimania can guide 6-day Machame, but ask us about 7-day Machame or 6-day Marangu first, as both usually suit a tight timeline better
- Highest possible summit probability is your single priority — Northern Circuit’s longer profile outperforms Machame in our data
- You have a medical condition requiring specific route selection
Machame Route Cost and What’s Included
Kilimania’s 7-day Machame price starts at $1,600 per person for a group of six and rises to $1,900 for a solo climber. This includes two hotel nights in Moshi, all Kilimanjaro National Park fees, KINAPA-licensed guides, an ethical porter team, tents, and meals.
| Group Size | Price Per Person (USD) | Ideal For |
|---|---|---|
| Solo (1) | $1,900 | Independent travelers |
| 2 | $1,800 | Couples or friends |
| 4 | $1,700 | Families |
| 6 | $1,600 | Best per-person value |
Included: 2 hotel nights, all KINAPA park and rescue fees, licensed guides, KPAP-standard porter team, tents, meals, daily SpO2 and Lake Louise monitoring, emergency oxygen, and airport/gate transfers.
Excluded: Flights, Tanzania visa, travel insurance, personal gear, Diamox or other medications, and crew gratuities (budget roughly $260–$350 per person — see our Kilimanjaro tipping guide with exact amounts).
KINAPA park fees run approximately $70 per person per day (verify current rates directly with KINAPA, as official fees are updated periodically and can include several components beyond the base park entry fee), so seven days alone total roughly $490 before any guide, porter, or meal cost is added. Based on Kilimania’s 2026 operating-cost model, a properly operated 7-day Machame requires approximately $1,400–$1,450 per person at the group level before normal commercial margins. This is not an industry-wide legal minimum — it is what our own cost structure produces when park fees, KPAP-standard porter wages, food, equipment, and transport are all accounted for. Other operators’ cost structures may differ. For a full breakdown of where the money goes, see Kilimanjaro climb costs explained.
Machame vs Other Routes
Machame shares terrain with Lemosho from Shira Camp onward, runs one day shorter, and costs slightly less — but sees noticeably more traffic on the first two days. The Northern Circuit trades an extra two days for the highest acclimatization margin and the quietest camps of any standard itinerary.
| Route | Duration | Kilimania Success Rate | Starting Price | Ideal For |
|---|---|---|---|---|
| Machame | 7 days | 92.3% | $1,600 pp | Scenic variety |
| Lemosho | 8 days | 94.8% | $1,750 pp | Fewer early crowds |
| Northern Circuit | 9 days | 96.1% | $1,900 pp | Highest acclimatization margin |
| Rongai | 6 days | 88.4% | Varies | Genuine 6-day timelines |
| Marangu | 6 days | 85.2% | From $1,450 pp | Hut accommodation |
All figures above are Kilimania’s own internally recorded outcomes, 2019–2025, not industry-wide averages. For the full breakdown across every route we guide, see Kilimanjaro success rate by route and our 2026 route comparison.
Camps, Water, Crowds, and Gear
Machame is a full camping route — Kilimania supplies tents, sleeping mats, mess tent, and treated water at every camp. Barranco is the most congested camp on the mountain in July–August; Barafu is the most exposed, with night temperatures regularly dropping to -10°C to -15°C. Bring a sleeping bag rated to at least -15°C comfort, broken-in waterproof boots (see our Kilimanjaro boots guide), trekking poles, and a headlamp with spare batteries for the midnight summit push. Full details in our complete Kilimanjaro packing list.
What Past Climbers Say
Rather than pull quotes out of context, we’d rather you read reviews directly on the platforms where they’re posted and verified by the platform itself:
FAQ: Machame Route Kilimanjaro
Is the 7-day Machame Route better than the 6-day version?
Kilimania recommends the 7-day itinerary because it includes an extra acclimatization night at Karanga Camp, which our climb records show improves summit outcomes. We still guide the 6-day version for clients with a tighter schedule, but we walk every client through the trade-off before booking.
What is the Machame Route success rate?
Kilimania’s internal records show 92.3% Uhuru Peak completion across 412 seven-day Machame climbs, 2019–2025 — our own operational data, not an industry-wide statistic.
How difficult is the Machame Route?
Kilimania rates it 8/10 among Kilimanjaro camping routes — our own editorial assessment, not an official industry scale. Expect a steep first day, the Barranco Wall scramble, and a long summit night. No technical climbing skills required.
How much does the Machame Route cost?
From $1,600 per person for a group of six, rising to $1,900 solo, including park fees, guides, porters, tents, and meals.
What is the Barranco Wall actually like?
A 250–300m non-technical scramble requiring hands at several points, including the Kissing Rock. No ropes or climbing gear needed.
Can a first-time trekker climb Machame?
Yes, with 3–4 months of dedicated training including loaded uphill hikes and proper pacing on the mountain itself.
When is the best time to climb Machame?
January–March and June–October are generally drier with better visibility. April–May brings the heaviest rain.
What’s the difference between Machame and Lemosho?
They share the same trail from Shira Camp onward. Lemosho’s approach sees far fewer climbers on the first two days and runs one day longer.
Is a Cheap Machame Quote a Scam?
A quote significantly under $1,400 per person for a 7-day Machame climb in a group usually means something is being cut. KINAPA park fees alone total roughly $490 per person for seven days before a single guide, porter, or meal is paid for.
Before paying any deposit, ask the operator:
- Are park fees itemised per day, in writing?
- Is the lead guide KINAPA-licensed — can you provide the license number?
- What is the guide-to-client ratio on summit night?
- Are porter wages aligned with KPAP standards?
- Is the operator TATO-registered — can you confirm the registration number?
Verify any operator’s TATO status at tatotz.org and current park fees at kilimanjaranationalpark.go.tz before booking.
Bottom Line
Machame suits fit, trained climbers who want scenic variety and can accept busy camps in peak season. It is not the route for climbers with only six days, or for anyone whose single priority is the highest possible summit probability — the Northern Circuit outperforms it on that measure in our data. The Karanga Camp overnight is the single most important acclimatization detail on this route, in Kilimania’s operational experience; skipping it is the one change we’re not willing to sell.
Plan Your Machame Climb
Send us your travel dates, group size, and any relevant medical or altitude considerations. We reply with a full itemised quote — park fees by day, guide-to-client ratio, KPAP compliance — within 12 hours.
WhatsApp +255 756 449 990 KINAPA-licensed guides · TATO-registered operatorConclusion
On the 7-day itinerary with the Karanga Camp night intact, Machame is one of Kilimanjaro’s strongest-performing camping routes in our own records — and the single biggest factor behind that is a decision to remove, not add. If your schedule allows seven full mountain days and you’re prepared to train for it, this route rewards the preparation. If it doesn’t fit your calendar, tell us honestly and we’ll point you toward a route that does. We Walk With You.
Data sources cited in this article: Kilimania Adventure’s internal booking and summit records, 2019–2026 (an internal dataset, pending final confirmation against booking and summit logs — see notes above); the CDC Yellow Book; Wilderness Medical Society altitude illness guidance; and KINAPA’s published fee schedule.
Medical disclaimer: This article describes altitude sickness risk and acclimatization physiology, referencing CDC and Wilderness Medical Society guidance. No guide, including Kilimania’s, can guarantee safety or a summit outcome. Individual physiology, undisclosed health conditions, and weather are variables no operator controls. Climbers with pre-existing conditions should get physician clearance before booking and disclose all relevant health information at the gate briefing. Specific physiological mechanisms described in this article are summarized from CDC and Wilderness Medical Society publications for educational purposes and do not replace professional medical advice. Kilimania’s operational observations are based on field experience and should be considered alongside, not in place of, individualized medical guidance.
Disclosure: Kilimania Adventure is a TATO-registered safari and Kilimanjaro operator based in Moshi, Tanzania, and has a commercial interest in Kilimanjaro bookings. Prices reflect our own 2026 operating costs. Success-rate data comes from our internal climb database, reflects our own operational outcomes rather than industry-wide averages, and remains pending final confirmation against booking and summit logs. We encourage you to compare quotes with at least two other TATO-registered operators before booking.
